The combined efforts of Seachios® Marine Services and the ship’s crew ensured the successful restoration of all cargo holds aboard the M/V Virtuous Striker.
The combined efforts of Seachios® Marine Services and the ship’s crew ensured the successful restoration of all cargo holds aboard the M/V Virtuous Striker.
The combined efforts of Seachios® Marine Services and the ship’s crew ensured the successful restoration of all cargo holds aboard the M/V Virtuous Striker.
Preliminary Information
A pre-inspection of the cargo holds aboard the M/V Virtuous Striker revealed significant operational challenges. The onboard supervisor identified the following:
Cargo Residues:

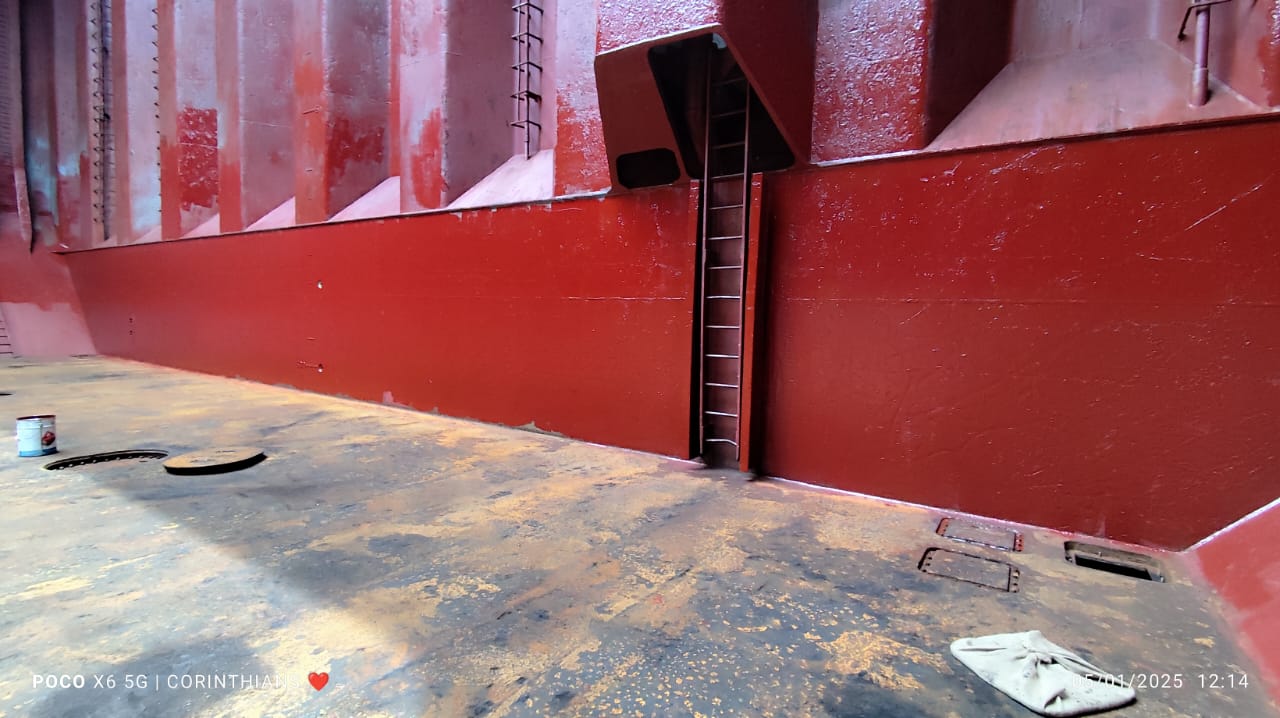

Heavy deposits from previous cargoes were adhered to key surfaces:Frames
Tank Tops
Bulkheads (Forward and Aft)
Severe Corrosion:
Rust was widespread across the structural components, with embedded cargo residues aggravating the issue.Black Stains:
Persistent black stains, particularly in heavily corroded areas, presented additional cleaning challenges.
Given these conditions, a detailed cleaning and painting plan was implemented to restore the cargo holds to acceptable operational standards.
Cleaning Operations
Timeline: December 31, 2024 – January 4, 2025
The cleaning process was carried out in four systematic phases:

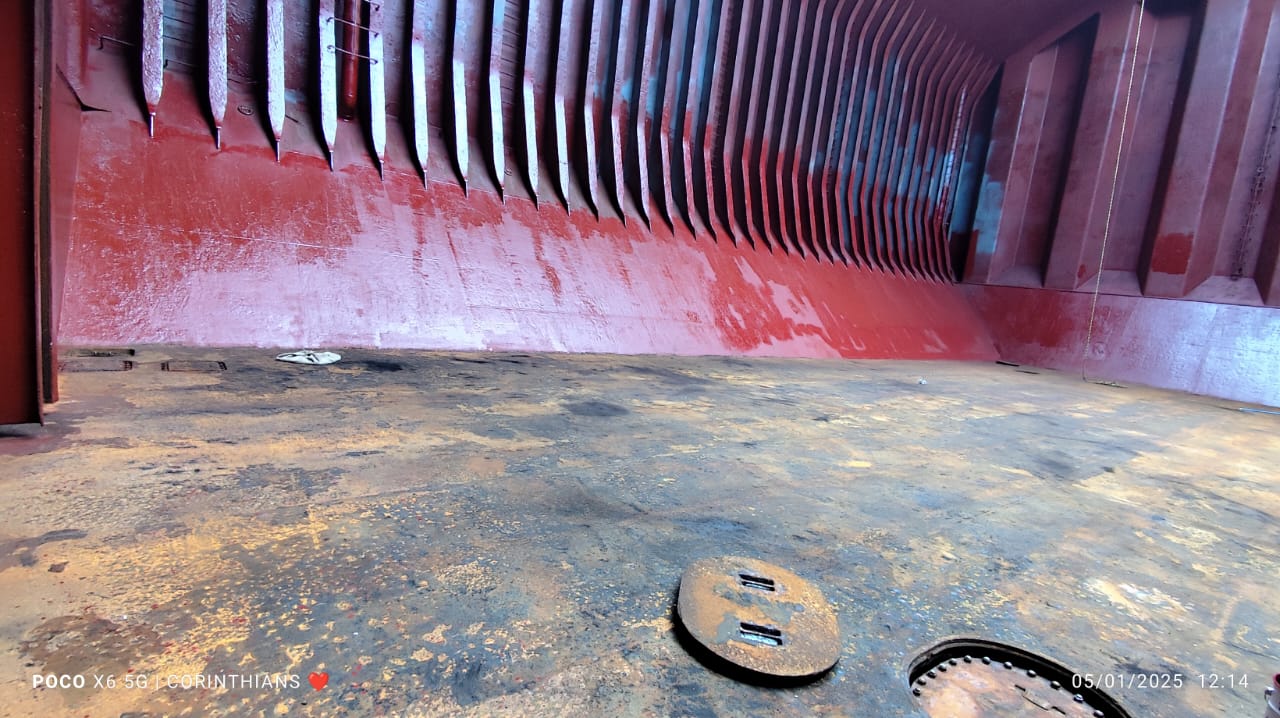

Phase 1: Seawater Washing
Objective: Remove heavy residues and loose contaminants.

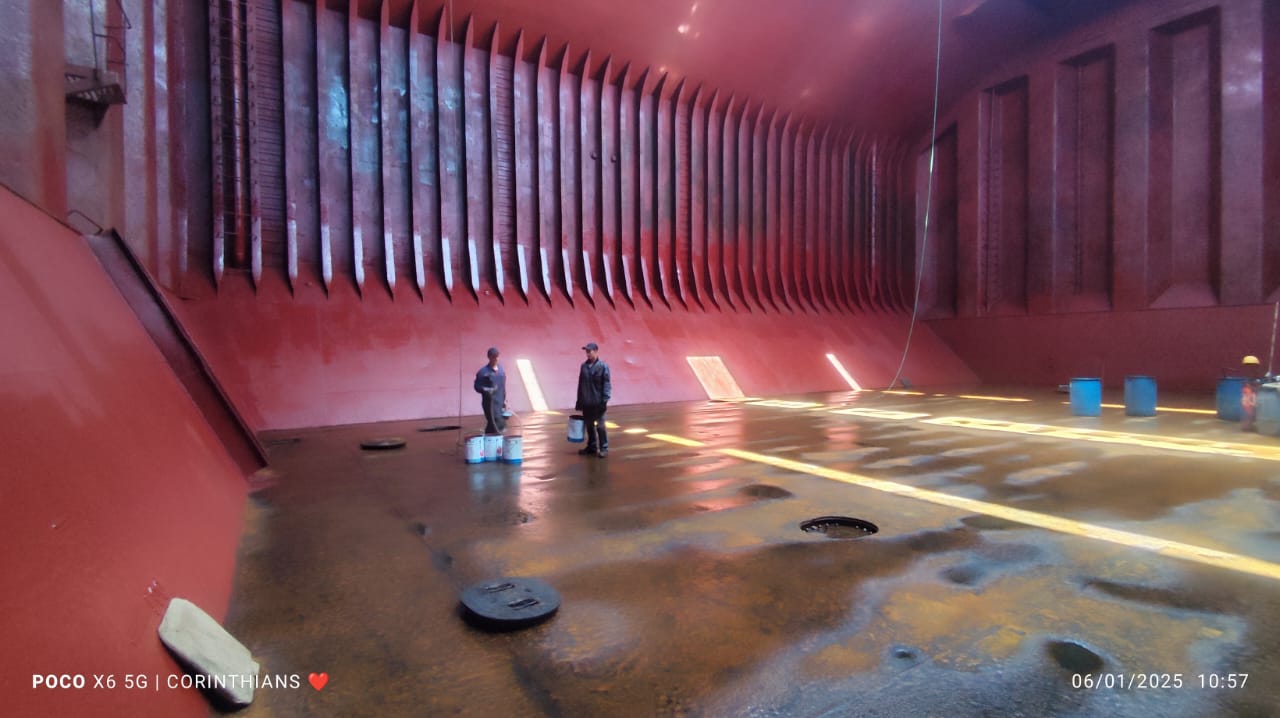

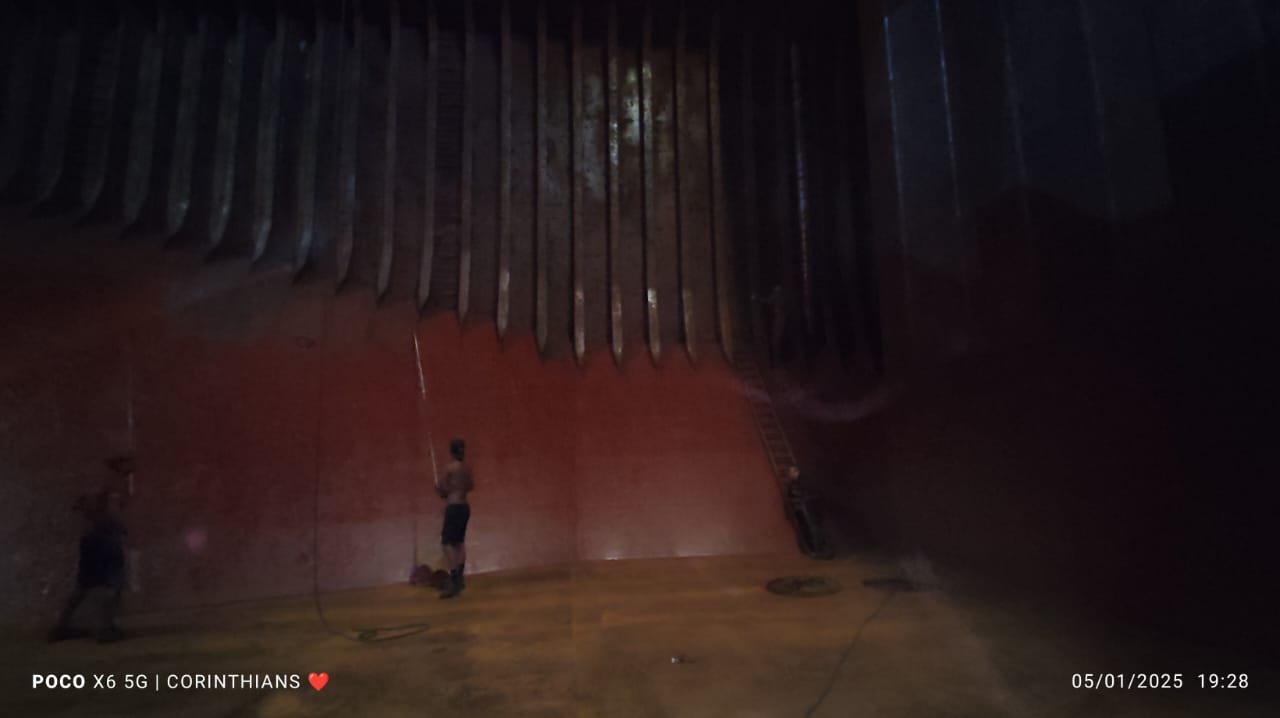

Process: High-pressure seawater was applied across all surfaces, including tank tops, frames, and bulkheads.
Outcome: Effective removal of surface-level debris.
Phase 2: Chemical Application and Manual Scrubbing

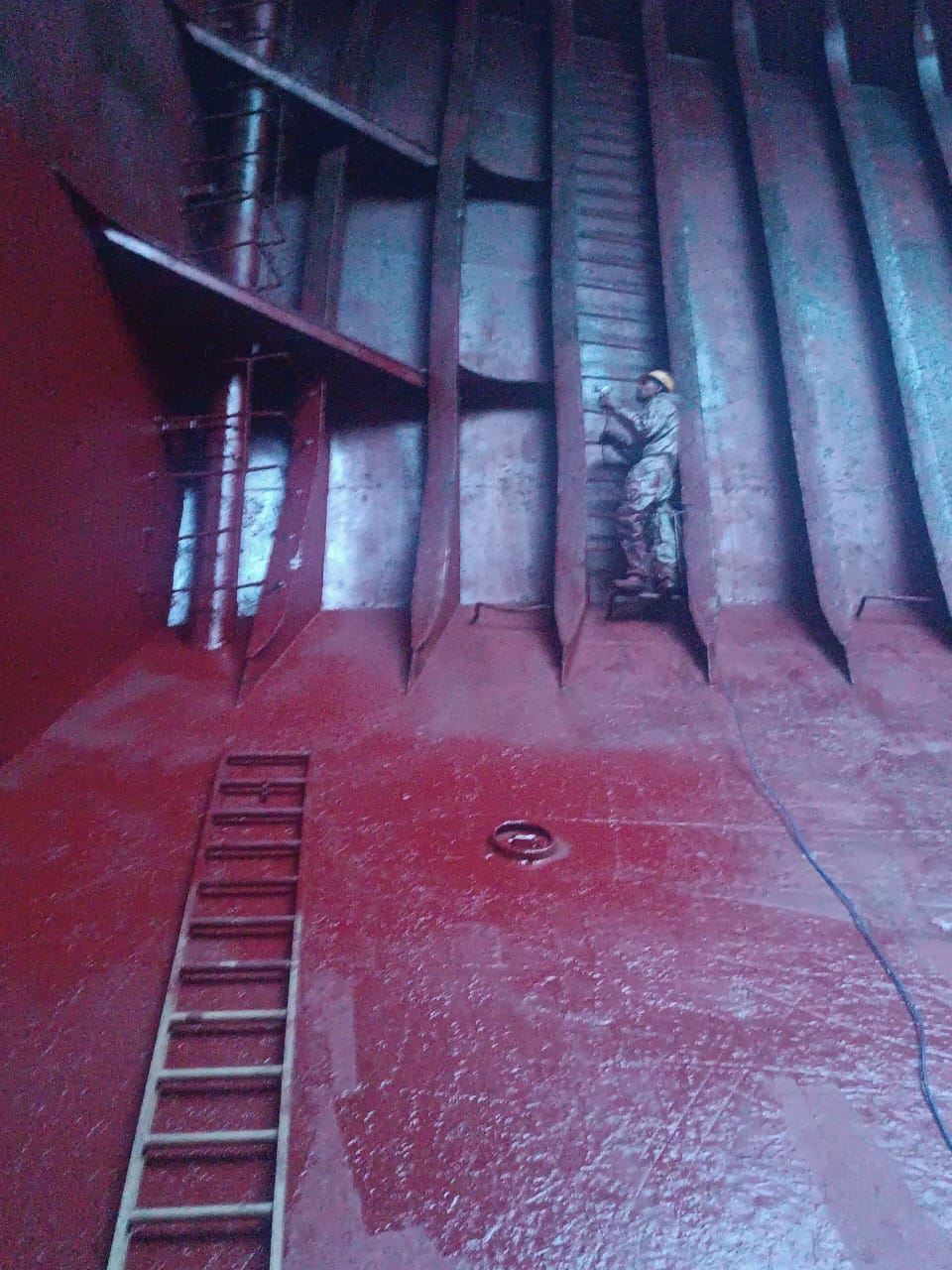

Objective: Target stubborn contaminants and embedded residues.
Process:
Application of biodegradable chemical cleaning agents to frames, hoppers, and bulkheads.
Manual scrubbing with sponges for deeper cleaning.
Outcome: Reduced contamination levels, though some black stains and rust persisted.
Phase 3: High-Pressure Hydroblasting

Objective: Eliminate deeply embedded residues and corrosion.

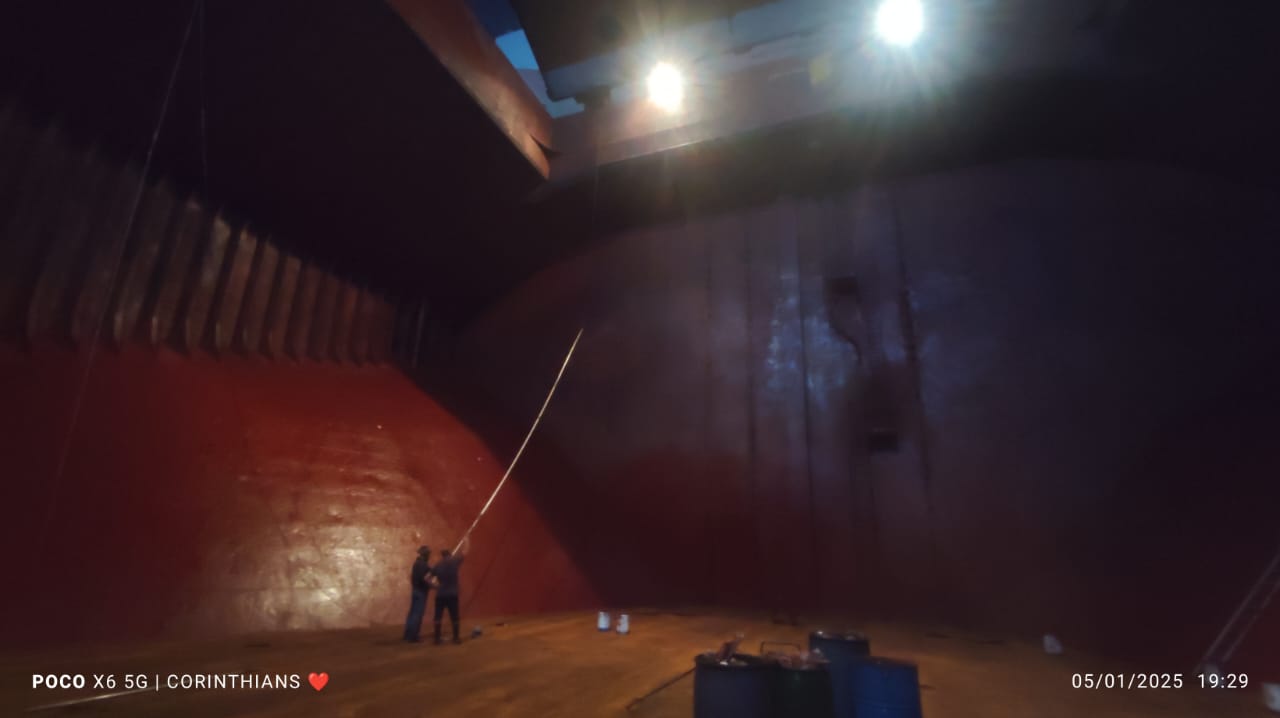

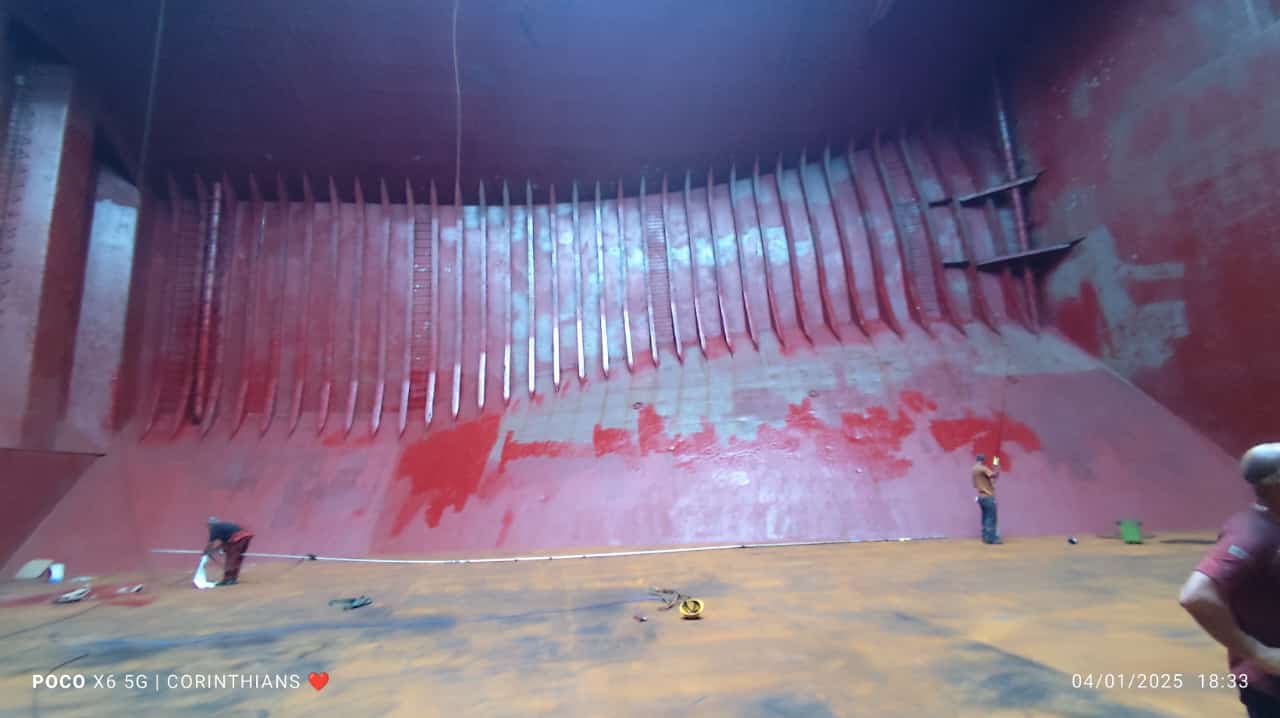

Process: Hydroblasting at 500–600 bar was conducted on all key surfaces.
Outcome: Significant reduction of contaminants; however, black stains and deep rust remained in some areas.
Phase 4: Freshwater Rinsing
Objective: Final cleaning to remove dust and residual chemicals.

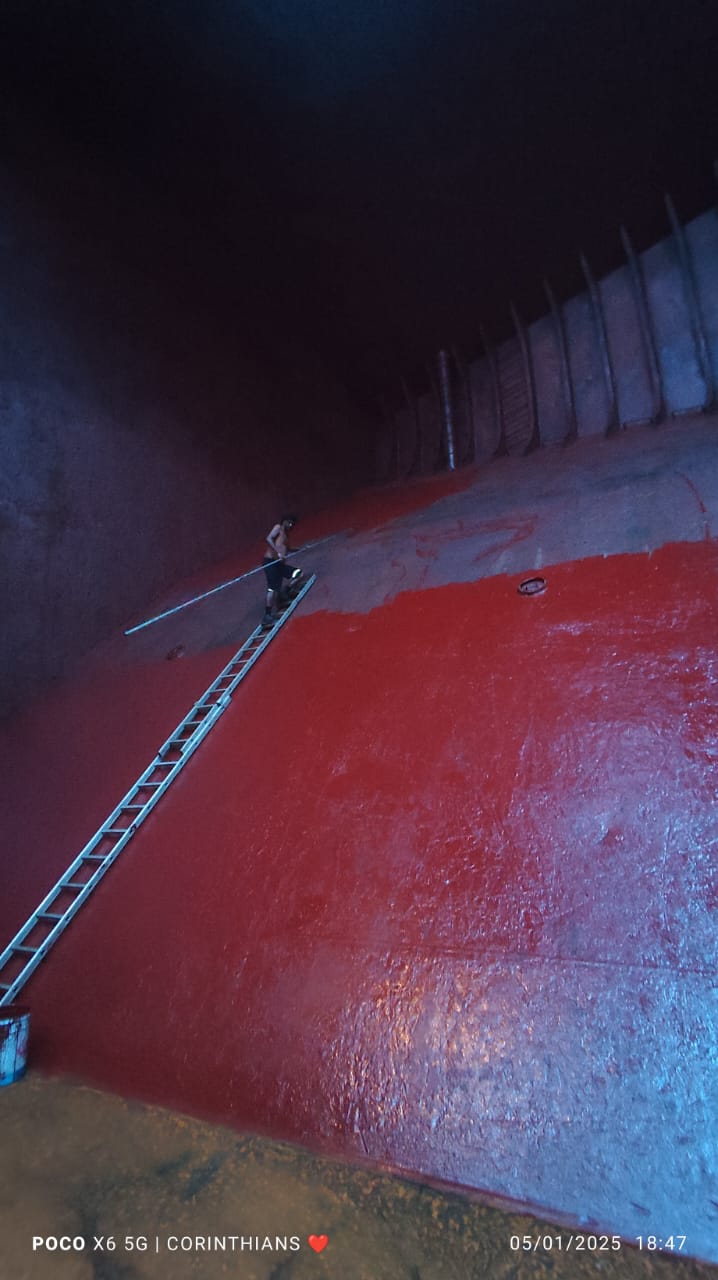

Process: Light-pressure freshwater rinsing covered all cleaned areas.

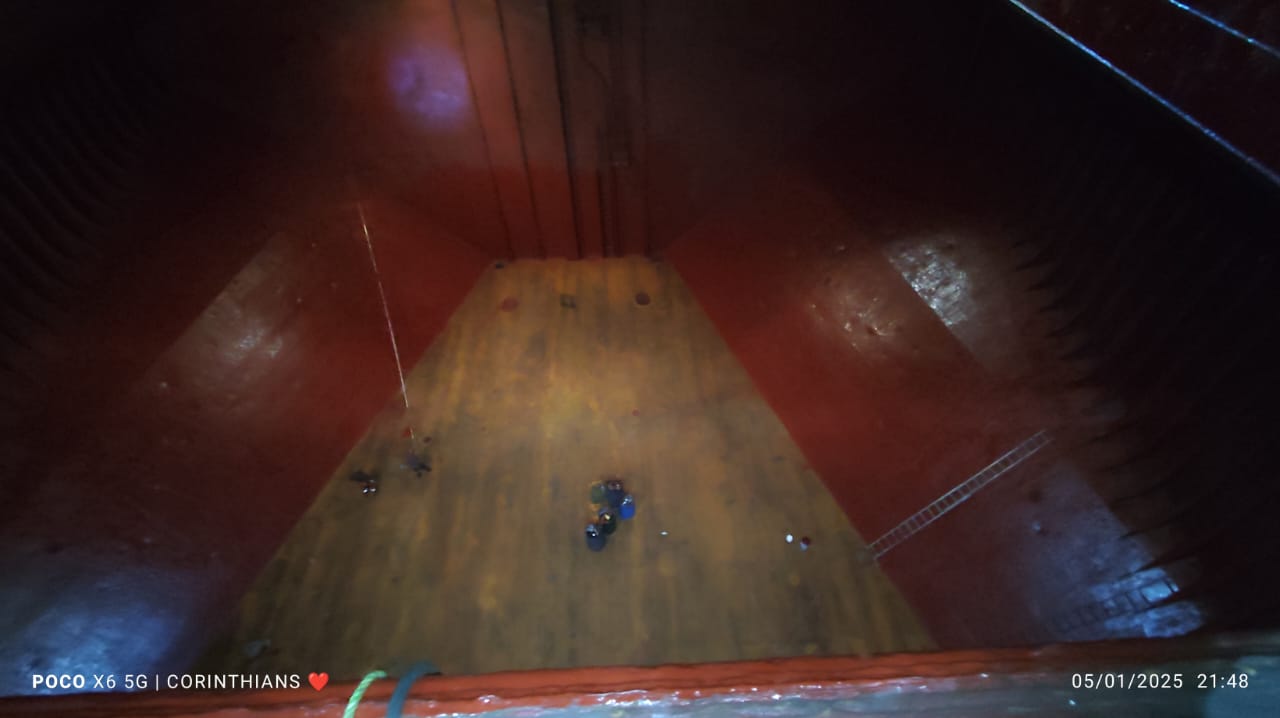

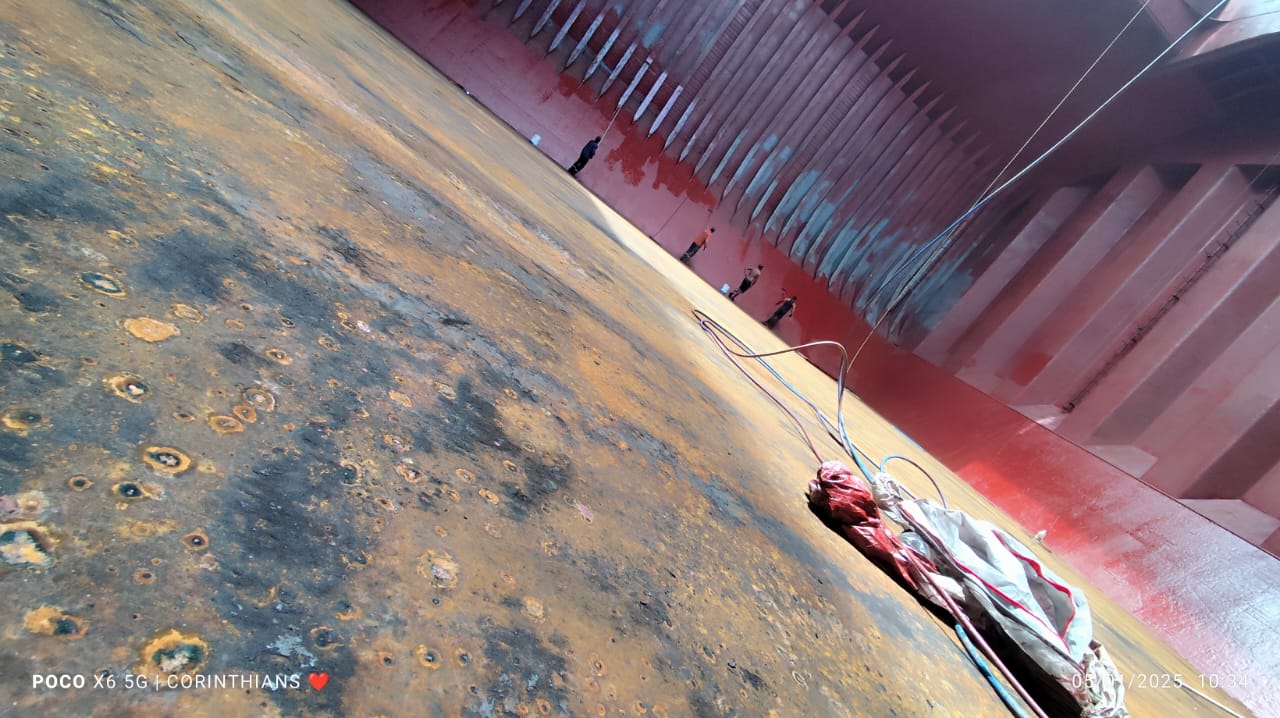

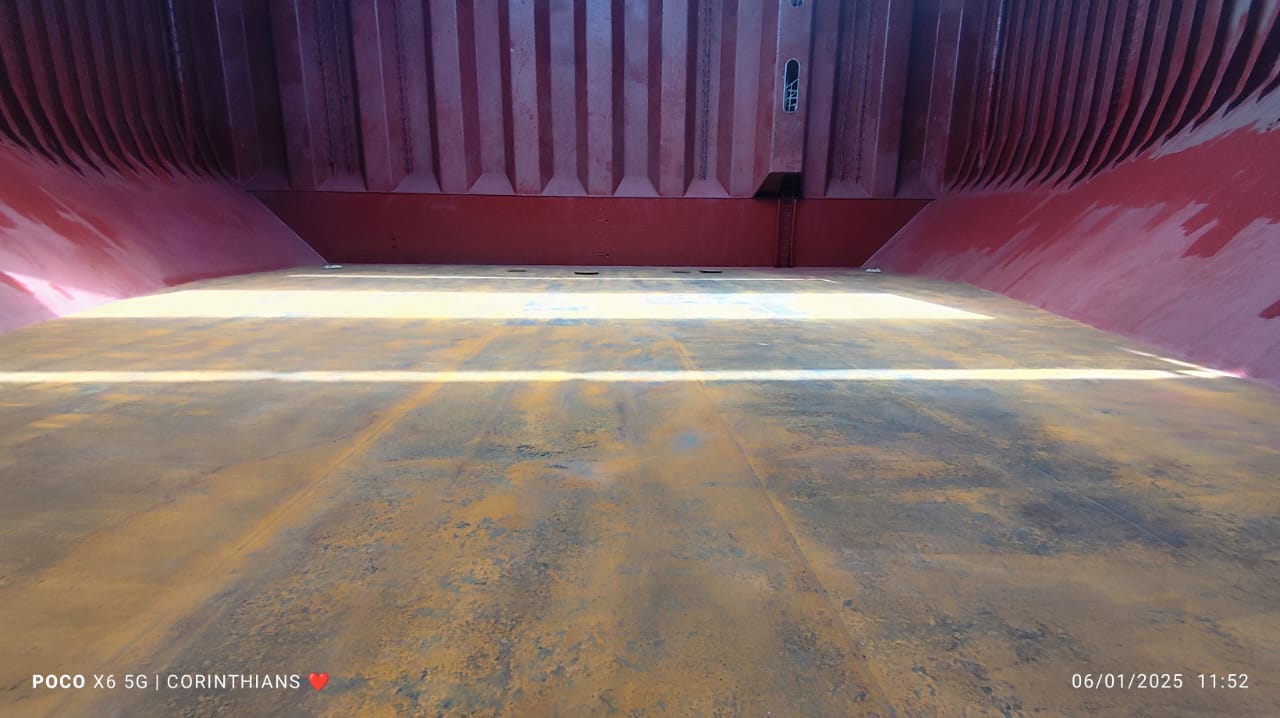

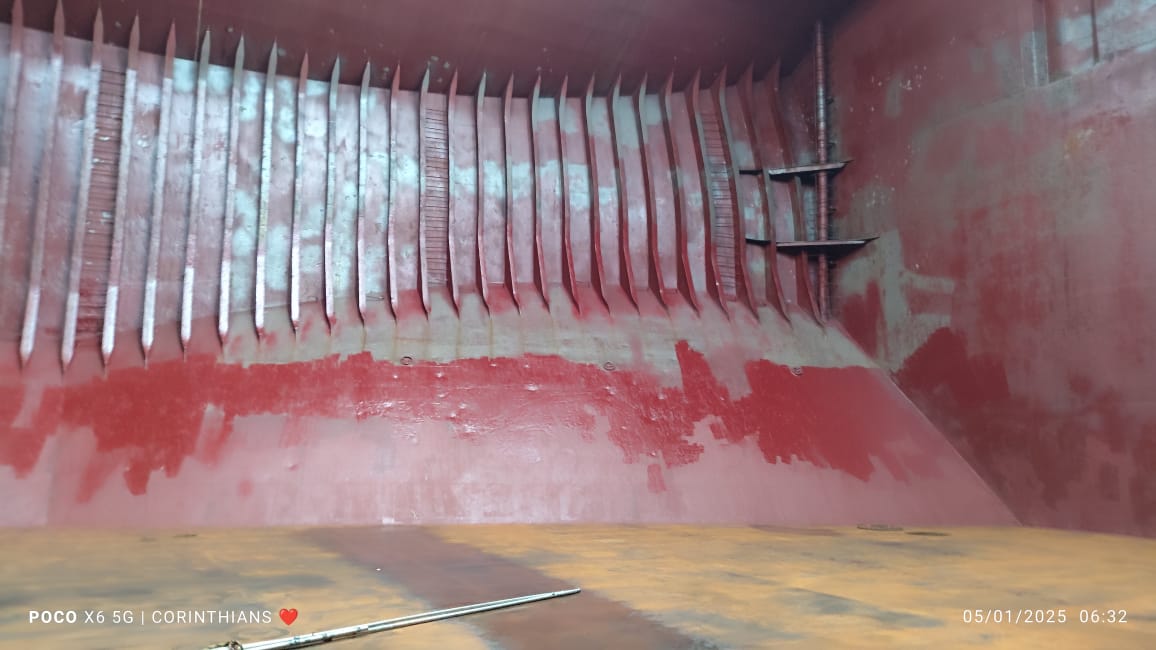

Outcome: Prepared the holds for inspection and painting.
Painting Operations
Timeline: January 4, 2025 – January 6, 2025
Painting was conducted to address persistent black stains, rust, and other imperfections that could not be resolved through cleaning alone.
Scope of Work
Ship's Crew Responsibilities:
Painted the hatch coamings.
Assisted in painting operations for Cargo Hold 01 and Cargo Hold 02.
Prepared and monitored airless equipment and paint for the Seachios® team.
Seachios® Team Responsibilities:

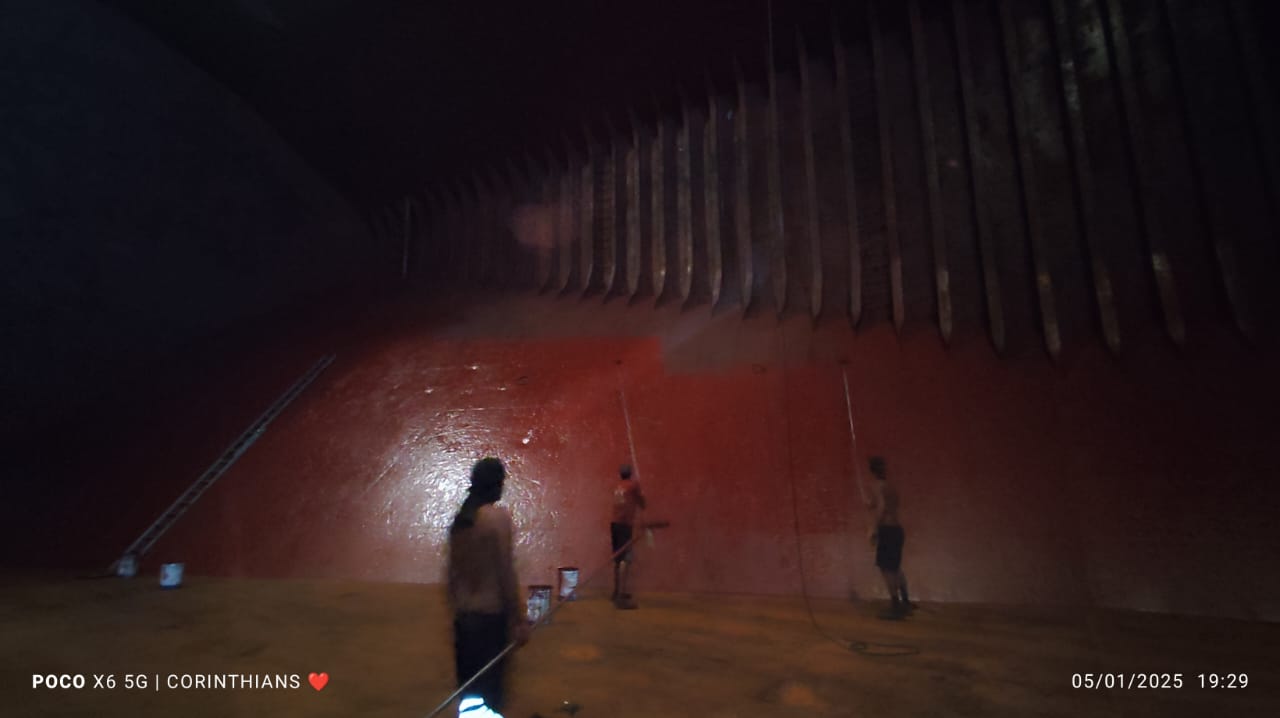

Completed all interior painting for Cargo Hold 01–05, ensuring compliance with maritime standards.
Painting Process
Surface Preparation:
Final cleaning and dust removal.
Preparation of frames, hoppers, and bulkheads for paint application.

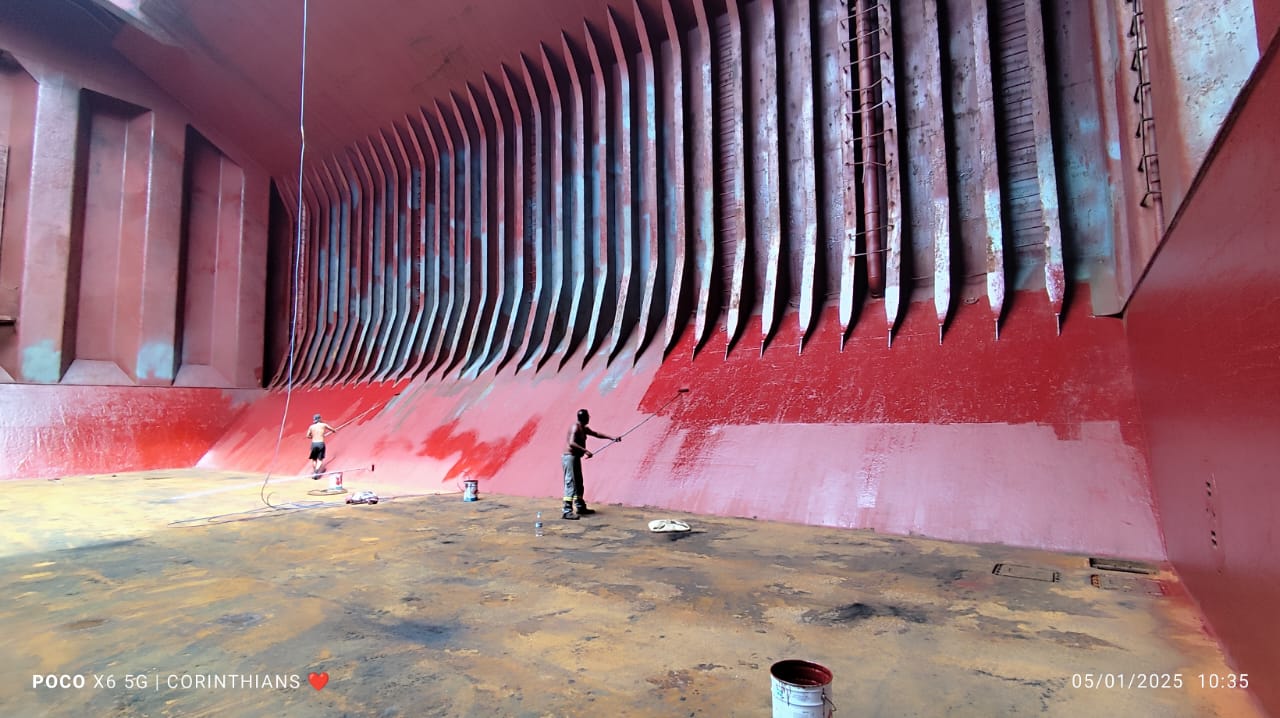

Painting Application:

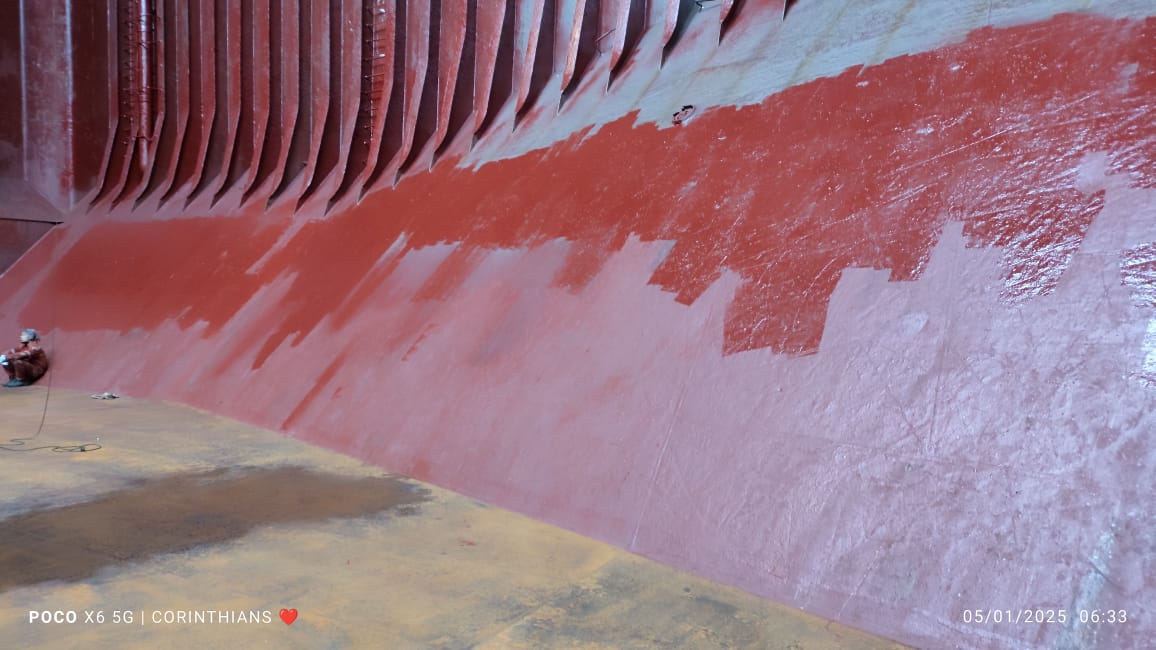

Marine-grade coatings were applied to:

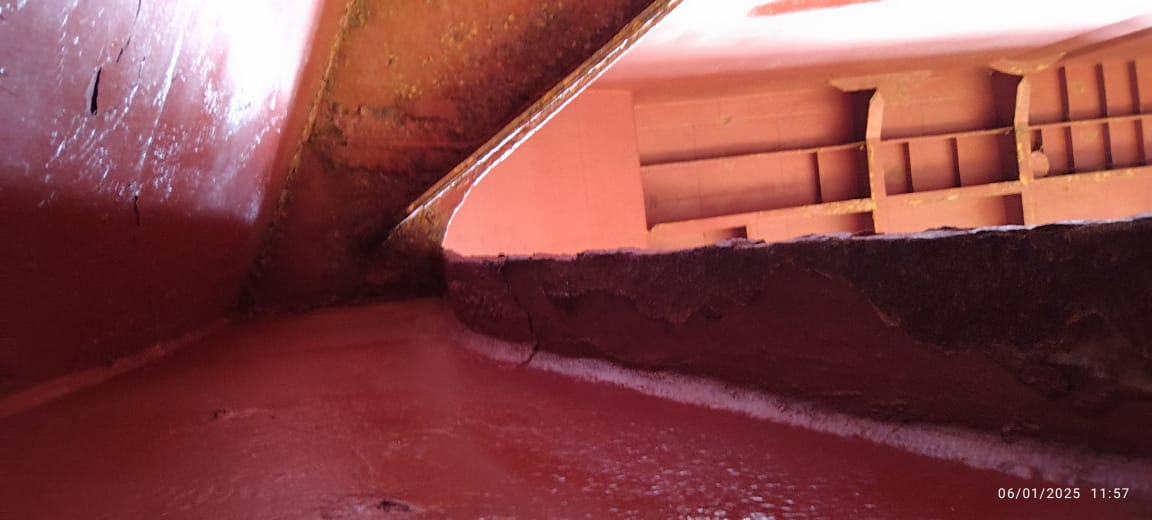

Forward Bulkheads
Aft Bulkheads
Frames
Tank Tops
Hoppers

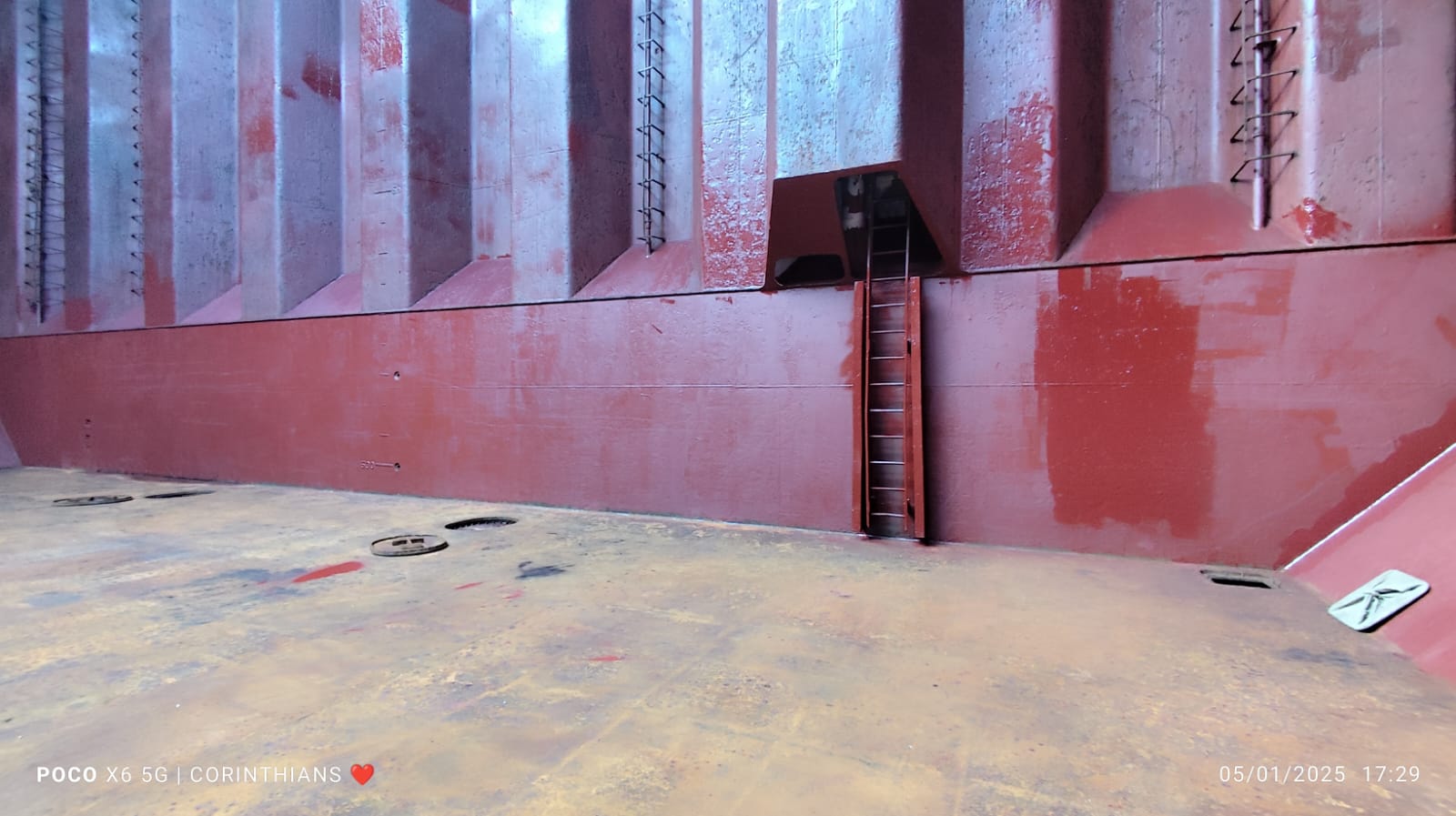

Ensured full coverage and durability.
Final Rinse:

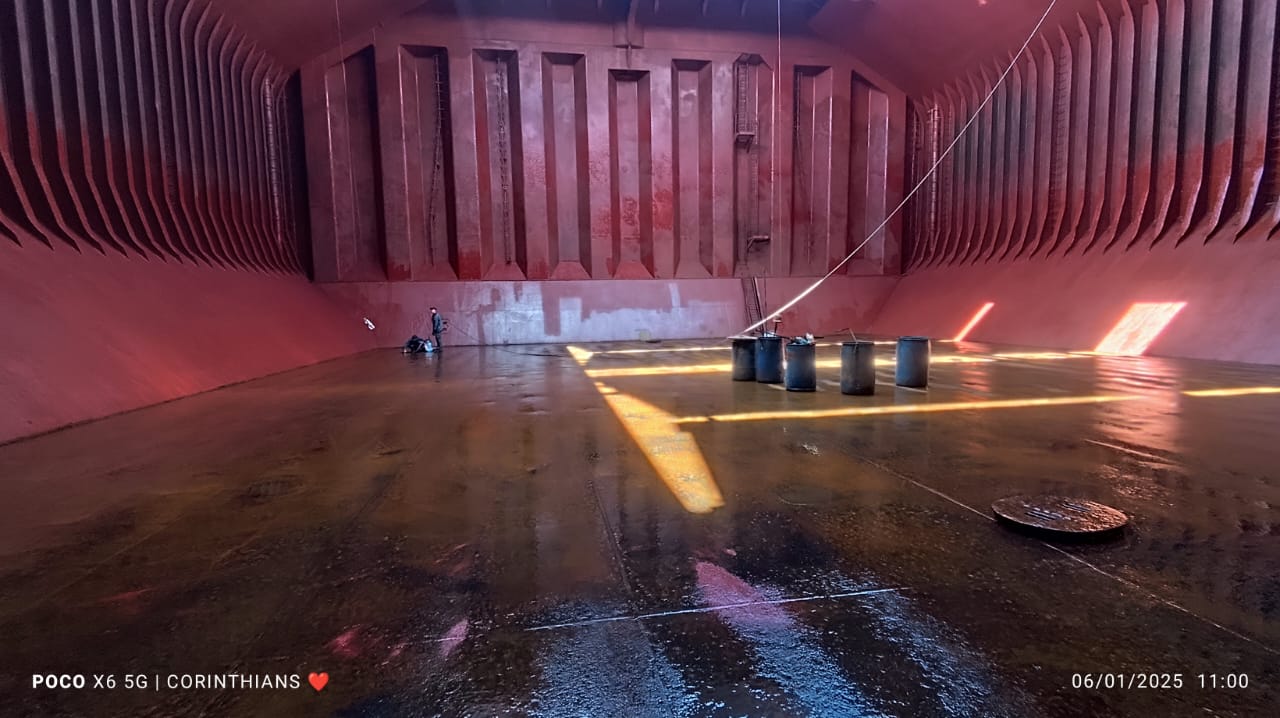

Light freshwater wash was performed post-painting to remove dust and overspray.

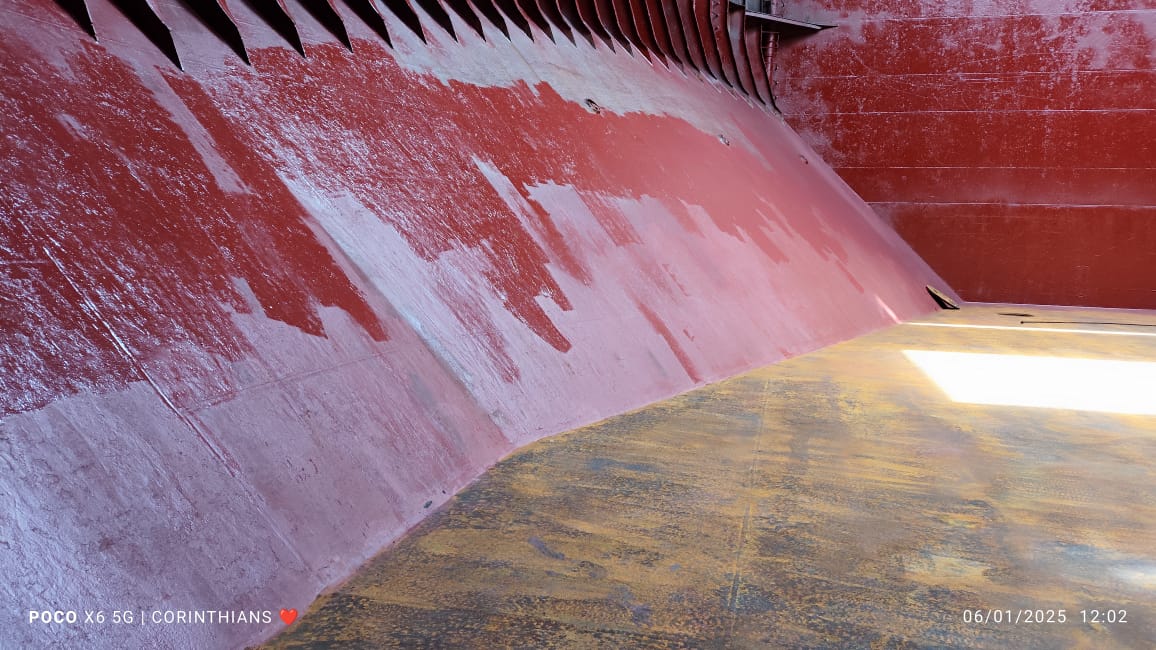

Detailed Painting Completion Data
Cargo Hold 01
Forward Bulkhead: 70%
Aft Bulkhead: 60%
Hoppers: 40%
Frames: 50%
Average Completion: 55.0%
Cargo Hold 02
Forward Bulkhead: 60%
Aft Bulkhead: 50%
Hoppers: 40%
Frames: 50%
Average Completion: 50.0%
Cargo Hold 03
Forward Bulkhead: 70%
Aft Bulkhead: 40%
Hoppers: 100%
Frames: 50%
Average Completion: 65.0%
Cargo Hold 04
Forward Bulkhead: 80%
Aft Bulkhead: 60%
Hoppers: 100%
Frames: 50%
Average Completion: 72.5%
Cargo Hold 05
Forward Bulkhead: 70%
Aft Bulkhead: 85%
Hoppers: 100%
Frames: 50%
Average Completion: 76.25%
Summary of Results
Average Painting Percentage per Hold:
Cargo Hold 01: 55.0%
Cargo Hold 02: 50.0%
Cargo Hold 03: 65.0%
Cargo Hold 04: 72.5%
Cargo Hold 05: 76.25%
Overall Average Painting Percentage: 63.75%
Highest Painting Completion: Cargo Hold 05 (76.25%)
Remarks
The combined efforts of Seachios® Marine Services and the ship’s crew ensured the successful restoration of all cargo holds aboard the M/V Virtuous Striker. Cleaning operations removed the majority of residues, while painting operations resolved issues related to black stains and corrosion. The cargo holds are now restored to hospital-standard cleanliness, ensuring readiness for inspection and future cargo operations.
For further information, please contact Seachios® Marine Services.
